Trend pillar

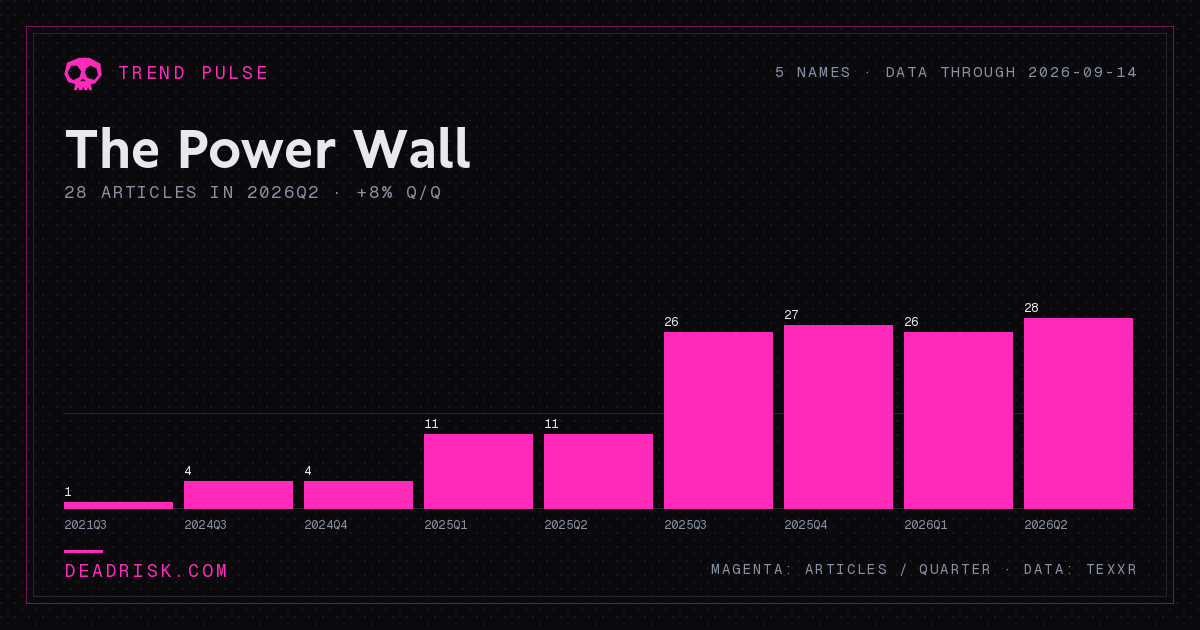

The Power Wall
The AI buildout's real limit isn't cash — it's permission to plug in. Grid queues, moratoriums, and the listed names on the scarce side of the wall.
Oracle and xAI Bypass Grids, Then Face Local Permit Opposition
The Thesis
Oracle and xAI bypassed grid queues, then ran into local permits.
Developers face grid-connection waits of up to seven years. On-site power can bypass that queue. It cannot bypass air, water, noise or construction approvals. On 18 July 2026, The Information reported that Oracle had switched from gas turbines to costlier fuel cells at Project Jupiter in New Mexico after permit hurdles, adding billions of dollars to planned cost. Reuters reported that xAI had installed unpermitted turbines at its Memphis site.
Money remains available through the AI-capex loop. This page tracks what money alone cannot clear. A power contract, a queue position and an operating permit are different things.
The Evidence
Coverage counts measure the archive, not the frequency of permit disputes. The screen covers every unique TEXXR article record dated 1 January 2024 through 21 July 2026 by source publication date. A case-insensitive search checks indexed headlines and TEXXR summaries. Every series requires data center* or data centre*. The siting series also requires permit*, zon*, moratorium*, ordinance*, oppos* or protest*; the power series requires power, grid*, MW, megawatt*, turbine* or nuclear. A record counts once per series per calendar quarter and may enter both series.
The siting screen found 2 records in 2024 Q2 and 22 in 2026 Q2, a derived 11.0x across eight quarter-to-quarter intervals. It found 11 from 1 through 21 July 2026; that is a partial-quarter count, not a Q3 pace estimate. The power screen found 11 records in 2024 Q1 and 79 in 2026 Q1, a derived 7.2x across eight intervals. Neither series measures permits issued, projects delayed or megawatts built.
The cost reached customers. Bloomberg put PJM power at $136.53/MWh in 2026 Q1, up 76% year over year from a derived baseline of about $77.57/MWh; it attributed the rise to data-center demand. PJM’s market monitor calculated in July that its latest capacity auction would add $6.3 billion to bills across 13 states and Washington DC through 2029. PJM proposed in January that large data centers bring generation or curtail. It expects demand to grow 4.8% annually on average over the next decade.
Local opposition had measurable results. In Virginia, the share of voters comfortable with new data-center construction fell to 35% in 2026 from 69% in 2023, a derived 34-point decline. A March 2026 Quinnipiac poll found 65% opposed local construction. Pew data cited by the FT put 67% of planned sites in rural areas, against 87% of existing sites in urban and suburban areas. A June study reported by NBC found opponents had blocked or delayed at least 75 US projects worth roughly $130 billion in 2026 Q1. It counted 833 organized groups across 49 states, against 396 at 2025’s end.
Seattle’s council voted 9-0 for a one-year pause in June. New York was at least the sixth state to introduce pause legislation when its bill was filed in February; its governor signed an up-to-one-year moratorium on new environmental permits for sites above 50MW in July, the first enacted state pause. Maine’s governor vetoed a similar bill in April because, the New York Times reported, it did not exempt a distressed mill-town project. Politico reported industry concern that New York’s action could prompt further restrictions. Proposals, vetoes and enacted pauses are not the same outcome. Reuters reported that HumansFirst said it organized 142 protests across 42 states on 18 July.
Bypass power has its own limits. The Wall Street Journal documented on-site plants bypassing grids in October 2025. By December, developers were turning to aeroderivative turbines and diesel generators. Electrek reported that Musk bought APR Energy, a mobile-turbine operator, for an implied $1 billion. Reuters reported that xAI’s Memphis pollution fell hardest on Black neighbourhoods; the turbines drew an NAACP lawsuit. Bloomberg found that transformer and switchgear shortages pushed builders toward Chinese imports, a link to the China stack. Nor is every proposed load firm: PJM cut its summer 2027 peak forecast to about 160GW from 164GW, a derived 4GW or 2.4% reduction. Bloomberg said some projects lacked firm service or construction commitments. That forecast and PJM’s decade-long growth estimate cover different horizons.
The Companies
Queue position, permission and generation are distinct assets. Applied Digital and TeraWulf converted bitcoin-mining sites with interconnection agreements and energised shells. TeraWulf’s July Anthropic lease runs 20 years and is worth about $19 billion for roughly 400MW in Kentucky. That total does not isolate queue position’s value. CoreWeave leases capacity rather than owning the interconnect. Microsoft entered talks for hundreds of megawatts at Abilene after Oracle left an expansion there. A prospective tenant change adds no site capacity.
IREN announced a May Nvidia deal to deploy up to 5GW of AI infrastructure; Nvidia retained a right to invest $2.1 billion. Bloom Energy supplies Oracle fuel cells. Their April agreement reached up to 2.8GW, days after Oracle received a warrant to buy $400 million of Bloom stock. Neither ceiling counts permitted, operating megawatts. Constellation Energy sits on the generation side of the same chain.
The baskets track power generation, grid equipment, nuclear restarts, data-center land and interconnects, miner conversions and energy storage. Capacity ambitions extend further: Zuckerberg’s January Meta Compute announcement targeted “tens of gigawatts” this decade. France booked €110 billion of proposals in one week, about 10GW, or roughly ten nuclear reactors in the FT’s comparison. Targets and proposals still need approvals.
The Lenses
The Helmer lens treats an existing interconnection agreement as a possible cornered resource under the seven powers: a rival cannot readily recreate its queue position. Policy could change that advantage. The White House was drafting a voluntary pact in February 2026, after Trump and Northeastern governors asked PJM in January to seek tech-funded generation. Neither record establishes shorter queues.
The Shiller lens uses narrative economics to ask whether a local cost dispute changes approvals. Microsoft’s January pledge to cover its power costs and reject tax breaks addressed two objections. The available record shows no resulting permit or measured change in support.
What Moved
Financing now has traded prices, not just reported talks. The New York Times reported on 17 October that CoreWeave bonds yielded more than 15% and some Oracle debt traded near 80 to 90 cents per dollar of face value, against 100 cents at par. TEXXR indexed that Times story on 18 and 19 October; those are two archive records of one report, not two bond-market observations. CNBC reported that CoreWeave bonds yielded near 15% on 14 October, when its shares closed down 15.5% from the prior session; Oracle fell 8.8%, Nebius 10% and Dell 11.3% on the same baseline. The reports describe different dates and CoreWeave yield levels. Neither establishes that Jupiter’s permits caused Oracle’s debt discount.
The October power record is a contract, not an operating permit. Reuters reported on 6 October that Google contracted with Constellation for 3,590MW on the largest US grid, with new nuclear energy accounting for about 25% of supply. Multiplying the rounded share by the contracted total gives a derived roughly 900MW of new nuclear supply. Reuters did not establish that all contracted megawatts were already generating or that the deal cleared local approvals.
Funding terms remain unsettled elsewhere. The Wall Street Journal, citing sources on 7 October, reported Broadcom sought over $50 billion in financing for OpenAI’s custom chip, while Oracle was in talks with Apollo and Goldman Sachs to finance a large chip purchase. These are reported talks, not completed loans. CNBC reported on 8 October that Oracle, Nvidia and CoreWeave shares had fallen after a report put OpenAI’s annualized revenue at September’s end $20 billion below an earlier figure. That is a difference between reported revenue figures, not evidence of a $20 billion decline in revenue over time.
Project Jupiter shows why financing and demand do not settle construction. Bloomberg, citing sources on 24 September, reported that Oracle sent a force majeure notice to Blue Owl. The notice seeks to delay payments tied to the 2.45GW New Mexico project if its 2028 launch is missed; Bloomberg did not establish that payments had stopped. The Wall Street Journal reported in late September that Jupiter’s power and permit hurdles remained unresolved. The FT, citing sources in mid-September, said about $18 billion of project-linked debt had entered stressed territory amid delay concerns and local pushback. Investor pricing, a notice and a missed launch are different outcomes; the last has not been established.
Other contracts describe demand, not energised capacity. The FT, citing sources on 1 October, reported Tencent’s Oracle lease: about $7 billion over five years for access to roughly 100,000 advanced AI chips through Southeast Asian sites; the report said the chips were unavailable in China. Bloomberg, citing sources on 3 September, reported Crusoe’s roughly $13 billion deal with Jane Street for GPUs and cloud infrastructure over five years, a derived average of $2.6 billion a year. Neither report supplied site permits or operating megawatts. Vanity Fair’s Ellison profile, published in October, describes Larry Ellison’s role in Oracle’s data-center ambitions but supplies no Jupiter permit decision.
The Information reported on 14 September that Amazon, Microsoft and Google were siding with consumers on power costs and improving community offers; it documented no resulting approvals. CNBC reported Oracle’s fiscal Q1 revenue of $19.35 billion, up 30% year over year against a $19.14 billion estimate. Cloud-infrastructure revenue was $7.4 billion, up 121% against a $7.09 billion estimate; net income rose 60% to $4.68 billion. Those operating figures do not resolve Jupiter’s permits.
DeadRisk’s confirmed project graph records on 14–15 October that American Electric Power plans to use Bloom Energy technology at its Cheyenne fuel-cell project in Wyoming. The graph supplies no capacity figure, permit or operating output for Cheyenne.
The DeadRisk market layer, not an issuer filing, records Oracle’s FY2026 capex at $55.7 billion for the year ended 31 May 2026, against $21.2 billion in FY2025. Revenue rose to $67.4 billion from $57.4 billion and operating cash flow to $32.0 billion from $20.8 billion. Free cash flow moved to negative $23.7 billion from negative $394 million; total debt reached $156.2 billion from $104.1 billion. Constellation’s FY2025 capex was $2.9 billion for the year ended 31 December 2025, against $2.6 billion in FY2024. Its free cash flow was positive $1.3 billion against negative $5.0 billion. These records describe different funding profiles, not permit status.
The same layer records Applied Digital’s FY2026 capex at $2.9 billion for the year ended 31 May 2026, from $681.6 million in FY2025. Revenue reached $611.3 million from $228.6 million; operating cash flow reached $89.7 million from negative $115.4 million. Free cash flow moved to negative $2.8 billion from negative $797.0 million, while debt reached $5.1 billion from $910.8 million. For FY2025, IREN’s capex was $1.4 billion against $479.9 million in FY2024, with free cash flow negative $1.1 billion against negative $427.7 million. TeraWulf’s FY2025 capex was $1.1 billion against $267.9 million in FY2024, with free cash flow negative $1.2 billion against negative $292.4 million. Bloom’s FY2025 capex was $56.8 million against $58.9 million in FY2024; free cash flow was positive $57.2 million against $33.1 million. The market layer puts GE Vernova FY2025 revenue at $38.1 billion against $34.9 billion in FY2024, and Vertiv at $10.2 billion against $8.0 billion. Those are supplier sales baselines, not approvals.
At the 23 October 2026 close, the DeadRisk market layer priced Applied Digital at $18.25, down 4.4% from the prior session, 33.0% against 30 days earlier and 45.3% against a year earlier. Bloom closed at $193.30, down 11.2% and 29.8% against the prior session and 30 days earlier, but up 90.6% against a year earlier. GE Vernova closed at $815, down 1.5% and 14.4% against the prior session and 30 days earlier, but up 36.9% against a year earlier. Vertiv closed at $194.32, down 0.7% and 21.9% on those shorter baselines, but up 6.1% against a year earlier. NUAI closed at $2.96, up 6.7% from the prior session but down 57.6% against 30 days earlier and 25.1% against a year earlier. At the 16 October close, Oracle was $128.23, down 4.6%, 10.4% and 59.0% against those three baselines; IREN was $26.99, down 11.2%, 36.7% and 56.4%. At the 9 October close, Constellation was $298.07, up 4.6% from its prior session and 1.4% against 30 days earlier, but down 21.8% against a year earlier. Prices do not identify a cause or measure physical progress.
Bloom filed results on 22 October; the provider’s calendar schedules GE Vernova and Vertiv for 28 October, IREN for 5 November, Constellation for 9 November, NUAI for 12 November, Oracle for 10 December 2026 and Applied Digital for 6 January 2027. These are provider dates, not filed dates, and can move.
- 2026-08-18All eight evidence-bearing names close lower than the prior session, from CEG at -4.09% to WULF at -11.25%; the derived median decline is 6.85%.
- 2026-08-10Anthropic, Macquarie, and Singapore's GIC form Theseus Infrastructure to develop AI computing sites — with Anthropic committing to cover consumer electricity price increases.
- 2026-08-08Amazon backs a 7.65GW gas plant for an off-grid Texas data center.
- 2026-07-31xAI says the 69 unpermitted gas turbines powering Colossus will not be fully removed until July 2027.
- 2026-07-22Pillar launch. Siting-conflict coverage stands at 22 articles for 2026 Q2, up from 2 in 2024 Q2, with 11 more logged in the first three weeks of Q3.
- 2026-07-18Oracle's Project Jupiter switches from gas turbines to fuel cells after permit hurdles, at a cost of billions more.
- 2026-07-18HumansFirst organises 142 protests across 42 states in a single day.
- 2026-07-14Musk buys mobile-turbine operator APR Energy for an implied $1 billion, taking generation in-house.
- 2026-07-14PJM's market monitor puts the latest auction's cost to customers at $6.3 billion through 2029.
- 2026-07-14New York becomes the first state to enact a data-center permit moratorium, covering sites above 50MW.
- 2026-06-12Study finds at least 75 US projects worth ~$130B blocked or delayed in one quarter; opposition groups double to 833.
Sources
Across 5 member names, 2026Q3 drew 29 articles against 28 in 2026Q2. The largest single move was Oracle, +12%.
